Once again, let
represent a topological graph in which is
a set of vertices and is the set of paths that map into
.
Under the multiple-query philosophy, motion planning is divided into
two phases of computation:
- [] Preprocessing Phase: During the preprocessing phase,
substantial effort is invested to build in a way that is useful
for quickly answering future queries. For this reason, it is called a
roadmap, which in some sense should be accessible from every part
of
.
- [] Query Phase: During the query phase, a pair,
and , is given. Each configuration must be connected easily
to using a local planner. Following this, a discrete search is
performed using any of the algorithms in Section 2.2 to
obtain a sequence of edges that forms a path from to
.

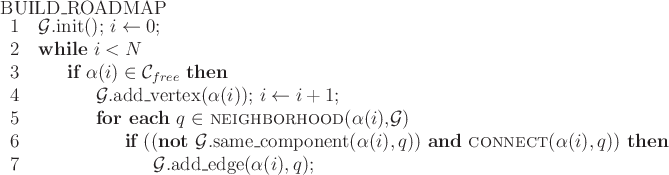

Figure 5.25:
The basic construction algorithm for
sampling-based roadmaps. Note that is not incremented if
is in collision. This forces to correctly count the
number of vertices in the roadmap.
|

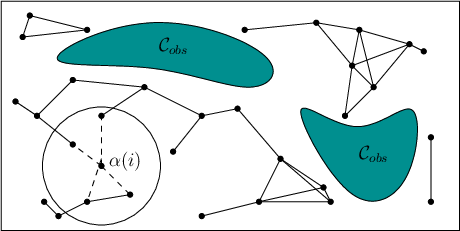

Figure 5.26:
The sampling-based roadmap is
constructed incrementally by attempting to connect each new sample,
, to nearby vertices in the roadmap.
|
