![]() |
Approximate solutions are much easier to construct, however, a
resolution parameter is introduced. Each path segment can be

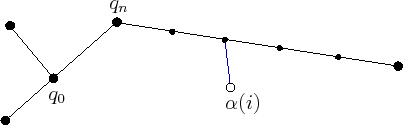

approximated by inserting intermediate vertices along long segments,
as shown in Figure 5.22. The intermediate vertices should
be added each time a new sample,
, is inserted into
.
A parameter
can be defined, and intermediate samples are
inserted to ensure that no two consecutive vertices in
are ever
further than
from each other. Using intermediate vertices,
the interiors of the edges in
are ignored when finding the nearest
point in
. The approximate computation of NEAREST is
performed by finding the closest vertex to
in
. This
approach is by far the simplest to implement. It also fits precisely
under the incremental sampling and searching framework from Section
5.4.1.
When using intermediate vertices, the trade-offs are clear. The
computation time for each evaluation of NEAREST is linear in the
number of vertices. Increasing the number of vertices improves the
quality of the approximation, but it also dramatically increases the
running time. One way to recover some of this cost is to insert the
vertices into an efficient data structure for nearest-neighbor
searching. One of the most practical and widely used data structures

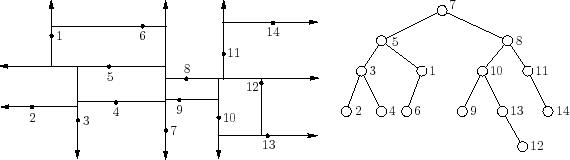

is the Kd-tree [264,365,758]. A
depiction is shown in Figure 5.23 for points in
. The Kd-tree can be considered as a multi-dimensional
generalization of a binary search tree. The Kd-tree is constructed
for points,
, in
as follows. Initially, sort the points
with respect to the
coordinate. Take the median point,
,
and divide
into two sets, depending on which side of a vertical
line through
the other points fall. For each of the two sides,
sort the points by the
coordinate and find their medians. Points
are divided at this level based on whether they are above or below
horizontal lines. At the next level of recursion, vertical lines are
used again, followed by horizontal again, and so on. The same idea
can be applied in
by cycling through the
coordinates,
instead of alternating between
and
, to form the divisions. In
[52], the Kd-tree is extended to topological spaces that
arise in motion planning and is shown to yield good performance for
RRTs and sampling-based roadmaps. A Kd-tree of
points can be
constructed in
time. Topological identifications must
be carefully considered when traversing the tree. To find the nearest
point in the tree to some given point, the query algorithm descends to
a leaf vertex whose associated region contains the query point, finds
all distances from the data points in this leaf to the query point,
and picks the closest one. Next, it recursively visits those
surrounding leaf vertices that are further from the query point than
the closest point found so far [47,52]. The nearest
point can be found in time logarithmic in
.
Unfortunately, these bounds hide a constant that increases
exponentially with the dimension, . In practice, the Kd-tree is
useful in motion planning for problems of up to about
dimensions.
After this, the performance usually degrades too much. As an
empirical rule, if there are more than
points, then the Kd-tree
should be more efficient than naive nearest neighbors. In general,
the trade-offs must be carefully considered in a particular application
to determine whether exact solutions, approximate solutions with naive
nearest-neighbor computations, or approximate solutions with Kd-trees
will be more efficient. There is also the issue of implementation
complexity, which probably has caused most people to prefer the
approximate solution with naive nearest-neighbor computations.
